What exactly is being built?

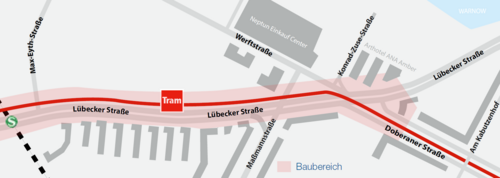

This summer, extensive construction work will take place in the Werftdreieck area around Hamburger Straße, Lübecker Straße (L22), Maßmannstraße, Werftstraße, Max-Eyth-Straße, Doberaner Straße and Am Kabutzenhof. The work is part of the preparatory measures for the residential development being built there. For public transport, this means that passengers should expect restrictions and changes to regular services until, it is anticipated, the end of August 2026.
The reason for these measures is extensive work on the infrastructure. In addition to the laying and renovation of water, gas and district heating pipes, a new tram track is being built between Max-Eyth-Straße and Doberaner Straße. This investment will strengthen the long-term capacity and reliability of the tram service at one of the city’s most important transport hubs.
The works are being carried out jointly by Stadtwerke Rostock AG, Nordwasser GmbH, Rostocker Straßenbahn AG and the Civil Engineering Office, and are closely coordinated. The aim is to minimise the impact on traffic – and in particular on public transport – as much as possible.
Rostocker Straßenbahn AG provides ongoing updates on all changes to scheduled services and the latest traffic reports. Passengers are asked to check their journey details before setting off.
Stages of construction during the project
| Period | RSAG construction project | Status |
|---|---|---|
| 13.07. - 24.07.2026 | Erection of mastsOverhead line worksDismantling of trackwork from the Max-Eyth-Straße crossing to the Maßmannstraße junctionDismantling of trackwork in the area of the Maßmannstraße stop (including dismantling of the stop)Construction of the new trackwork | done |
| 25.07. - 31.07.2026 | Dismantling of the track system at the L22 level crossingTrack and civil engineering works for the construction of the L22 level crossingErection of masts | done |
| 01.08. - 14.08.2026 | Track and civil engineering works for the construction of the Maßmannstraße level crossingConstruction of bus stops on MaßmannstraßeErection of additional masts | pending |
| 15.08. - 21.08.2026 | Dismantling and construction of the track system on Doberaner StraßeRemaining track worksOverhead line works and acceptance | pending |
